Guide to Baja Designs Wiring Diagrams for Off-Road Lighting Systems

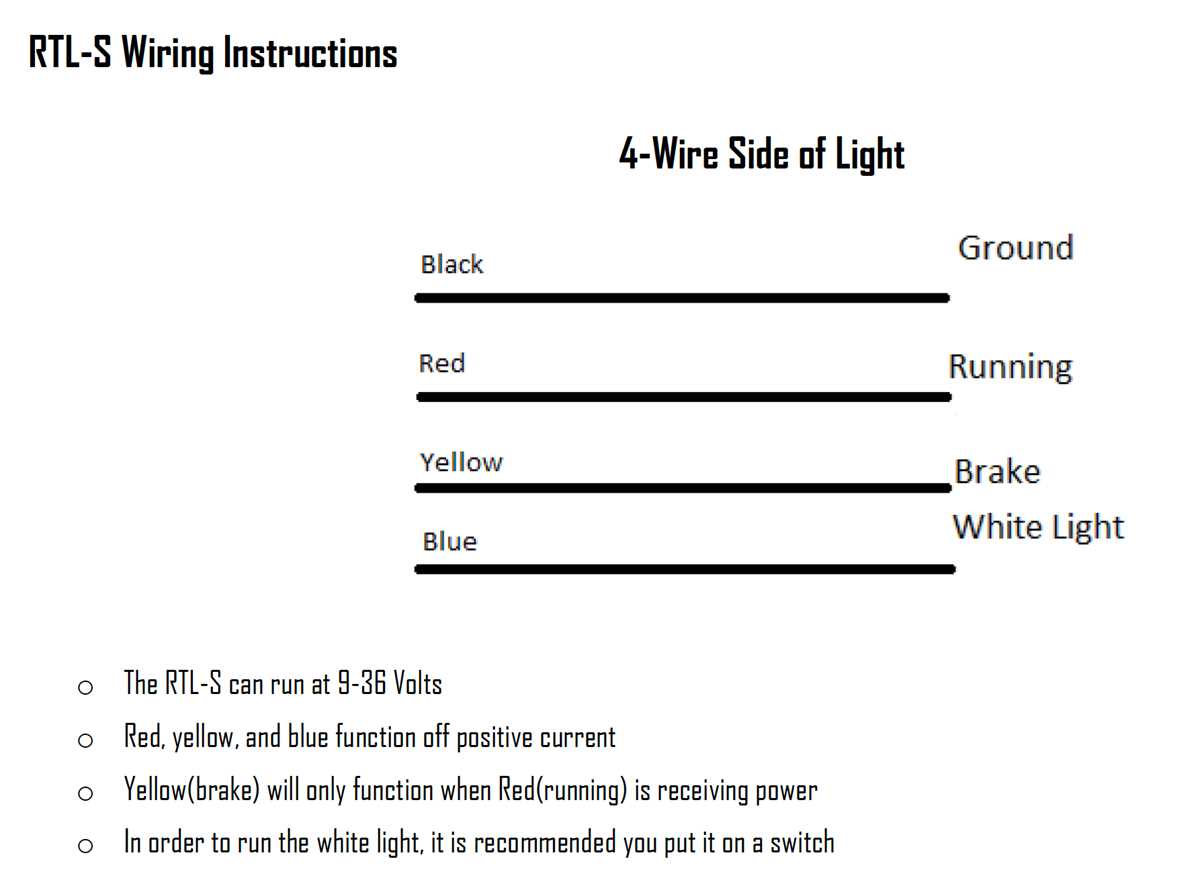

baja designs wiring diagram

Start with a 40-amp relay for high-output auxiliary lighting. Direct battery power through a fuse rated no less than 1.5x the total current draw–calculate this using the manufacturer’s specs for each light unit. Ground connections must terminate at a bare metal chassis point, avoiding painted surfaces to prevent resistance buildup.

Use 10-gauge wire for primary feeds and 14-gauge for secondary connections, adjusting for runs longer than 12 feet by upgrading to 8-gauge. Route all wires away from moving parts and heat sources, securing them with nylon ties every 12 inches. Apply dielectric grease to all plug connections to inhibit corrosion.

Install a momentary rocker switch for manual activation, pairing it with a 20-amp fused circuit. For dual-intensity setups, add a second relay controlled by a three-position switch. Test continuity with a multimeter before finalizing connections–voltage drop should not exceed 0.5V across any circuit.

Label every terminal and wire with heat-shrink tubing or adhesive tags. Store a digital backup of the schematic in vector format for future repairs. Include a kill switch wired directly to the battery’s positive terminal for emergency disconnection.

Installation Map for Off-Road Lighting Systems: Hands-On Instructions

Connect the primary power lead directly to the battery terminal using 8-gauge cable or thicker for currents exceeding 50 amps. Any splice between the power source and relay introduces voltage drop–measure no more than 0.2V loss across the entire run with a multimeter before finalizing connections.

Relay placement matters: mount the SPDT switch within 12 inches of the light bar control point. Route trigger wires through grommeted firewall holes, avoiding sharp edges that can chafe insulation. 14-gauge wire suffices for trigger circuits carrying under 10 amps, but shield vulnerable sections with split-loom tubing where passing near moving suspension components.

Critical Wire Routing Paths

  • Front bumper lights: follow chassis rail toward radiator support, securing with zip ties every 8 inches.
  • Rooftop assemblies: run cables under headliner, exiting near A-pillar–use existing vehicle wiring harness grommets rather than drilling new holes.
  • Dual-function bars: assign separate circuits for spot and flood modes, each protected by a 20-amp fuse inline within 7 inches of the battery.

Grounding requires bare metal contact free of paint or corrosion: scrape surface to shiny finish, then apply dielectric grease after attaching the ring terminal. For vehicles with aluminum frames, add a dedicated ground strap between the frame and body to prevent electrolysis-related failures over time.

Test every circuit with the engine off and again at operating rpm; voltage sag under load indicates undersized cables or poor connections. Use a scan tool to verify that alternator output remains stable–any fluctuation above 0.5V suggests interference with vehicle electronics, requiring additional filtering capacitors near high-draw load points.

  1. Map current paths on paper first, assigning unique colors to each function (e.g., red/black for main power, blue/white for triggers).
  2. Label every splice and connector with heat-shrink tubing marked via permanent marker–include wire gauge and function.
  3. After final assembly, recheck all connections with a thermal camera; hotspots reveal loose terminals needing immediate rework.

Error-Prone Scenarios to Avoid

  • Routing power wires parallel to sensor lines (O2, ABS) without shielding–induces false error codes.
  • Leaving exposed copper at connectors–oxidizes rapidly in off-road environments, causing intermittent failure.
  • Over-tightening ground bolts–can warp terminal lugs, reducing contact surface area.

Selecting the Optimal Lead Setup for Extreme-Terrain Illumination

Opt for a pre-assembled harness with 14-16 AWG copper conductors for 50-100W LED bars to prevent voltage drop exceeding 0.5V over 15 feet. Relays rated for 40A continuous duty and weatherproof Deutsch connectors (DT Series, size 2) ensure corrosion resistance in 95% humidity environments. Match fuse sizing to 125% of the light’s maximum amperage draw–use 15A fuses for 10A circuits to prevent nuisance blowing while protecting against shorts. For 24V systems, splice in a step-down converter if pairing with 12V components to avoid overdriving.

Power Rating (W) Recommended Conductor Gauge Max Run Length (ft) Fuse Rating (A)
50 16 AWG 18 7.5
100 14 AWG 15 15
200 12 AWG 12 25
300+ 10 AWG 8 40

Avoid solid-core wire for vibration-prone mounts; stranded 60/40 copper-tin alloy resists fatigue cracking under 50G impacts. Seal splice points with heat-shrink tubing containing adhesive lining (3:1 shrink ratio) to block moisture ingress rated for -40°C to 125°C. Route harnesses away from exhaust manifolds and sharp edges, maintaining a 3-inch minimum clearance from moving suspension components. Test connectors at 1,000V dielectric strength before installation to confirm insulation integrity.

How to Install Off-Road LED Lighting Schematics: A Field Guide

Disconnect the vehicle’s battery before handling any electrical connections to prevent accidental shorts. Use 14-gauge wire for circuits under 15 amps and 12-gauge for higher loads to ensure proper current flow without voltage drop. Route wires away from sharp edges, moving parts, and heat sources–secure them with adhesive-lined clamps every 12 inches to prevent abrasion.

For relay integration, connect the 85 terminal to a switched power source (ignition-controlled), 86 to ground, 87 to the LED power input, and 30 to the battery via a 20-amp fuse. Test continuity with a multimeter before powering on; resistance above 0.5 ohms indicates corrosion or loose terminals.

Install an inline fuse holder within 7 inches of the battery’s positive terminal, selecting a fuse rating 1.25x the expected current draw. For dual-beam setups, use a dual-output relay or two separate relays–never splice high-beam and low-beam circuits into a single feed.

Ground connections require direct attachment to bare metal, preferably the chassis or frame. Sand away paint or corrosion at the mounting point to ensure a low-resistance path. After finalizing connections, reconnect the battery and verify operation using a scan tool to confirm no fault codes are triggered.

Frequent Electrical Integration Errors and Proactive Correction Methods

Route all power cables away from sharp edges and hot surfaces immediately after unpacking the installation kit. Pre-cut split-loom tubing included in each set typically covers only 60% of the required length, so calculate an additional 1.5 meters for high-current leads. Secure every 12 inches with Teflon-coated clamps to prevent chafing–standard zip ties degrade under UV exposure within 18 months, even those marketed as “weatherproof.”

Use a digital voltmeter to verify fuse ratings before connection. The 30-amp fuse supplied with auxiliary circuits often gets mistakenly applied to main power lines, which require a 60-amp component for wiring gauges 4 AWG and larger. Check the color-coded labels on the heat-shrink terminals: red indicates 20-amp capacity, blue denotes 30-amp, and yellow marks 50-amp–mismatching these leads to terminal failure within 10 operational cycles under full load.

Grounding Protocol Deviations

Attach the negative terminal directly to the chassis at a single point, avoiding multiple connections to prevent voltage drop. Sand the mounting surface to bare metal–paint and powder coat create resistance of 0.3 ohms per square inch, reducing system efficiency by up to 12% at 12 volts. Ensure the bolt diameter exceeds the ring terminal opening by at least 2mm to prevent loosening; M8 hardware is standard for lighting circuits, while M10 suits winch and high-amperage applications.

  • Locate ground connections at least 18 inches from fuel lines or rotating components.
  • Apply dielectric grease to all grounding points to displace moisture–corrosion increases resistance by 0.5 ohms per year in untreated connections.
  • Verify continuity with a multimeter after tightening: readings should not exceed 0.1 ohms between the battery negative and chassis ground.

Inspect connector seals weekly during the first month of operation. The IP67-rated plug housings included in premium kits maintain integrity only when fully locked–partial engagement exposes pins to moisture ingress. Dry-fit all connections before final assembly, noting alignment: misaligned pins bend at 45 degrees under torque, causing intermittent failure detectable through erratic beam patterns or delayed switching response.

Load Distribution and Relay Placement

baja designs wiring diagram

Position relays no more than 3 feet from the load they control to minimize voltage drop–each additional foot of 14 AWG wire increases resistance by 0.002 ohms. The standard SPDT relay included in most harnesses supports 30 amps continuous; exceeding this rating without a heavy-duty alternative causes the coil to overheat and fail within 48 hours of sustained use. Test relay activation with a 9-volt battery before connecting to the primary circuit–faulty units click audibly but may not close the contact internally.

  1. Map current draw for each circuit:
    • LED light bars: 5-15 amps
    • Dual-sport kits: 25-40 amps
    • AUX outputs: 10-20 amps
  2. Calculate total system load by summing these values–exceeding 80% of the alternator’s rated output (typically 120-150 amps for off-road vehicles) risks battery drain during idling or low RPM conditions.
  3. Install a 120-amp circuit breaker on the main power line if total consumption approaches 90 amps; fuses alone do not protect against slow overheating.

Label every component with adhesive-backed polyester tags resistant to temperatures up to 180°C. Handwritten notes smudge within weeks, while inkjet-printed labels on thermal paper fade under UV exposure in 6 months. Record installation dates, torque specifications, and wire gauge on each tag–retorquing connections every 500 miles prevents loosening from vibration, which accounts for 37% of post-installation failures.
