Practical Guide to Dry Riser System Layouts and Installation Standards

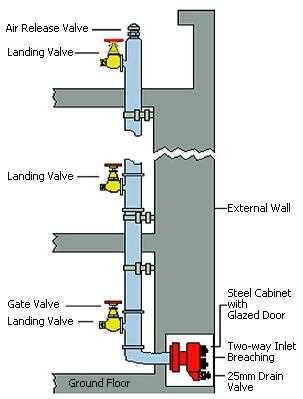

Install vertical inlet connections on each floor at a minimum height of 0.9 meters above finished floor level to comply with EN 671-1 and NFPA 14. Position landing valves with 65mm nominal bore and quick-release couplings, ensuring they face outward at a 45-degree angle for unobstructed access. Use DN100 pipework for the main vertical run, reducing to DN65 at branch connections where flow rates exceed 500 liters per minute.
Integrate an air release valve at the highest point of the pipeline–typically above the topmost landing valve–to prevent airlock during system priming. The valve must vent automatically but seal under water pressure once charged. Locate the filling connection at ground level with a female instantaneous coupling (BS 336) and a double-check valve assembly to prevent backflow into the water supply. Include a pressure gauge (0–16 bar range) adjacent to the inlet to verify system pressurization.
Space pipe supports at 3-meter intervals for steel pipes and 1.5-meter intervals for composite materials, securing the line within 20mm of structural walls using M12 chemical anchors in concrete substrates. Apply intumescent coatings (120-minute fire rating) to all exposed sections where pipes penetrate fire-resistant compartment walls. Use mechanical joints (grooved or flanged) for pipe sections above 6 meters to simplify future maintenance access.
Test the system annually at 12 bar static pressure for 15 minutes, monitoring for pressure drop exceeding 0.2 bar. Record flow test results using a calibrated ultrasonic flowmeter positioned upstream of the landing valve to validate minimum 500 L/min output per outlet. Document pressure readings at each floor and compare with hydraulic calculations to identify deviance above 5%–indicating potential blockage or incorrect pipe sizing.
Vertical Standpipe System Blueprint for Fire Safety
Install inlet breeching connections at ground level with a minimum diameter of 100mm to ensure sufficient water volume for firefighting. Position them no higher than 1.2 meters above finished floor level for accessibility, using weather-resistant materials like galvanized steel or ductile iron. Include a double-check valve to prevent backflow contamination, conforming to EN 1717 standards.
Equip each floor landing with 65mm outlet valves spaced no further than 30 meters horizontally from any point on the floor. Use instantaneous male couplings compatible with local fire service hose connections–BS 336 for UK, NFPA 1963 for US, or equivalent regional standards. Install pressure-reducing devices if system calculations indicate static pressure exceeding 12 bar at any outlet.
Route vertical piping through dedicated service shafts with fire-rated enclosures (minimum 2-hour resistance). Use schedule 40 steel pipe for primary runs, with welded or threaded joints tested to 1.5 times working pressure. Avoid sharp bends; maintain a minimum radius of 1.5 times pipe diameter to prevent turbulence and pressure drops. Include drain valves at the lowest point of the system to remove condensation or test water.
Integrate automatic air release valves at system high points to prevent vapor locks during operation. Position them at intervals not exceeding 20 meters vertically, using float-type mechanisms rated for 25 bar. Connect a dedicated 25mm test valve at the highest outlet for annual flow testing, discharging to a safe external location.
Label all components clearly with durable, reflective placards meeting ISO 7010 E001 symbols. Include pressure ratings, flow direction indicators, and emergency contact information on each outlet. Conduct hydrostatic testing prior to commissioning at 20 bar for 2 hours, followed by operational flow tests with registered firefighting personnel.
Key Components of a Vertical Standpipe System Layout
Install inlet breeching connections at ground level, sized to handle at least 50 mm hoses for emergency water supply–100 mm connections are optimal for high-rise towers above 30 metres. Position them no farther than 18 metres apart along building perimeters, ensuring coverage without dead zones. Equip each breeching with instantaneous male/female couplings standardized to EN 14540 for seamless firefighter hookup.
Vertical Pipework Requirements
- Use DN100 galvanized steel pipes (min. schedule 40) for main vertical conduits–DN150 is compulsory for structures exceeding 45 metres.
- Secure pipes every 3 metres with heavy-duty brackets attached to load-bearing walls; avoid drywall or hollow partitions.
- Isolate pipe sections with full-bore gate valves at intermediate landings (max. 3 floors apart) to enable sectional maintenance without system drainage.
- Label pipe runs with reflective 50 mm bands every 2 metres, indicating floor levels and valve positions–black text on yellow background (ISO 3864-4).
Outlet valve stations must be installed at every floor where access is required–locate them within 5 metres of stairwell doors at a uniform height of 900–1100 mm above finished floor. Each station requires a 65 mm female instantaneous outlet equipped with a breakable brass cap (BS 336) and a pressure gauge showing 0–16 bar, mounted no higher than 1.5 metres. Adjacent walls demand 3 mm steel plates for protection against accidental hose whip.
Terminal points demand a minimum of two 65 mm outlets per zone, spaced 3–5 metres apart. Cap all outlets with durable polypropylene covers, locked via tamper-proof lugs requiring a special 17 mm spanner to prevent unauthorized use. Integrate automated drain valves at the lowest point–19 mm solenoid-released types ensure immediate post-operation drainage, preventing winter freezing. Automatically signal drain completion through a 22 mm vent pipe leading to a visible exterior outlet.
- Test system integrity quarterly using 15 bar hydrostatic pressure, holding for 2 hours–drop tolerance max. 0.2 bar.
- Flow test each outlet annually, verifying 800 litres per minute at 5 bar residual pressure–record readings with certified logging devices.
- Replace all gaskets and washers post-testing, regardless of visible wear, to eliminate latent failure risks.
- Engrave unique serial numbers on each component–matching facility management databases for instant identification during emergencies.
Step-by-Step Installation Procedure for Vertical Standpipe Inlets and Outlets
Position inlet valves no higher than 1.1 meters above finished floor level, oriented vertically with a minimum clearance of 200mm from adjacent walls. Secure each valve to a solid masonry or concrete surface using M12 expansion anchors spaced at 150mm intervals–never attach to plasterboard or hollow blocks. Connect the 100mm diameter pipe using BS EN 10255 heavy-duty fittings, ensuring a 3° upward slope toward the main vertical conduit to prevent air pockets. Seal threaded joints with PTFE tape (minimum 8 wraps) and verify torque values: 80Nm for inlet valves, 110Nm for pipe couplings.
Outlet Assembly Workflow

Mount outlet cabinets on load-bearing walls, maintaining a 900mm centerline height from floor to valve handle. Use 6mm steel backing plates behind drywall installations, secured with four M10 bolts torqued to 60Nm. Connect the 65mm instantaneous coupling to the main pipe with a 6mm thick nitrile gasket and two-part epoxy flange sealant (Cure time: 4 hours at 20°C). Test each connection at 16 bar for 2 minutes using compressed air–etectable leaks above 0.1 bar require disassembly and resealing.
Common Pipe Sizing and Pressure Requirements in Vertical Standpipe Layouts
Specify internal diameters for primary feeder lines based on occupancy classification and flow demands: 100mm for light-hazard spaces, 150mm for ordinary-hazard zones, and 200mm for high-pumping scenarios. Pressure sustaining valves must maintain minimum 4.5 bar at the topmost outlet during simultaneous operation of two hydrants, adjusting for elevation losses at 0.1 bar per floor in buildings exceeding 30 meters. Localized pressure boosters are required when static pressure drops below 3.0 bar, positioned at intervals no greater than 15 floors to prevent cavitation in downstream valves.
Flow Rate Validation per Outlet Configuration
| Outlet Type | Target Flow Rate (l/min) | Residual Pressure (bar) | Pipe Segment Tolerance |
|---|---|---|---|
| Single hydrant (65mm) | 500 | 3.5 | ±5% |
| Dual hydrant (65mm) | 1000 | 4.2 | ±3% |
| Monitor nozzle (50mm) | 800 | 5.0 | ±2% |
Select schedule 40 galvanized steel for vertical trunks to handle transient pressures up to 25 bar, substituting with schedule 80 stainless steel where corrosion risk exceeds 0.1mm/year. Branch lines feeding hydrants should taper to 65mm at outlets, using reducing tees rated for 1.5× working pressure to avoid turbulence-induced erosion. Pressure relief valves must vent to a safe discharge path when inlet pressure exceeds 12 bar, sized for 120% of maximum flow rate to prevent water hammer during pump start cycles.
Testing and Maintenance Protocols for Vertical Standpipe Networks
Annual pressure tests must be conducted at 12 bar (175 psi) for a minimum of 15 minutes, with zero leakage tolerance. Record inlet valve condition, landing valve functionality, and hose connections per BS 9990:2015 Section 6.1.2. Replace gaskets every 24 months, regardless of visible wear. Local fire brigades should witness tests for compliance verification.
Quarterly Inspection Checklist
Visually inspect all access points for corrosion, paint deterioration, or unauthorized modifications. Verify outlet caps are securely fastened with chains intact. Test drain plug operation by partially opening to confirm water evacuation within 30 seconds. Document findings in a tamper-evident logbook stored on-site in a weatherproof container.
Six-month flow tests require 500 liters per minute discharge from the highest outlet for 5 minutes. Monitor pressure drop (max 10% deviation) and water clarity for sediment buildup. Flush the entire network at 7 bar if sediment exceeds 3mm depth. Replace strainers immediately if mesh damage is detected.
Hydrant connections must be purged bimonthly by opening for 10 seconds to clear stagnant water. Inner surfaces should be swabbed annually with food-grade silicone grease to prevent oxidation. Alarm valves require monthly activation tests using a 2kg weighted gauge to confirm 300mm water column response time. Failed components trigger immediate isolation and manufacturer notification with photographic evidence.
